• City of Tacoma QA
  • City of Tacoma Data




Taylor Way Rehabilitation

Project Updates



Construction Begins July 7--Please Watch for Workers in the Roadway

Taylor Way Vicinity

Construction is expected to begin the week of July 7, 2020 (pending permits) and will be primarily focused on Taylor Way from E. 11th Street to SR 509. The work will generally include demolition, utility placement, rail crossing replacement and paving.  Tentative dates and activities include:

  • July 7 - Site preparation/erosion control installation.
  • July 9 - Digging/Potholing in roadway at select locations.
  • July 16 – Taylor Way from E. 11th Street to Lincoln Avenue will be reduced to one lane (direction varies) into October, a detour will be in place via Alexander Avenue. Note, this section of roadway may be reduced to one-way flagger controlled or totally closed at night or over weekends.
  • July 20 – Taylor Way from Lincoln Avenue to SR 509 will be reduced to two lanes, one lane in each direction. Two lanes will remain in place through 2021 (approximate timeframe of re-opening roadway to three lanes will be posted based on weather and construction progress). Note, this section of roadway may be reduced to one-way flagger controlled or totally closed at night or over weekends.

Please watch for website updates including additional general road closure/detour route information and specific updates on rail crossing work with associated three day total road closures/detour routes.



Business and pedestrian access will be maintained.



SR 509 Vicinity

No roadway work on SR 509 is planned for the near term, however, there will be some clearing activities occurring in the wooded area south of SR 509 over the next 1-2 months.



Website updates will be made during construction to provide information on construction progress and upcoming work. Port of Tacoma will also provide project updates through text and email alerts. Sign up to receive these alerts through their Subscribe to Updates webpage or via text message: text PORT ROADWORK to 468311 (message and data rates apply).



Project News



Virtual Pre-Construction Open House was held on May 27, 2020, watch the recorded event here.

To send questions or for more information on the project, contact Project Manager Mark D'Andrea at mdandrea@cityoftacoma.org or (253) 591-5518.



Project Schedule

  • July 2020 – Construction Begins
  • September 2021 - Work Generally Complete (weather dependent)
  • September - November 2021 - Final Finishes/Punch List Items

Getting Around During Construction

To minimize impacts to the traveling public, construction that will reduce lanes on Taylor Way (to less than one lane in each direction) and on SR 509 (to less than two lanes in each direction) will occur at night and/or on weekends.  This generally involves major paving operations, but could include occur other tasks such as utility installation, roadway striping, etc.



Project Outreach

Outreach is ongoing and has included two open houses (August 24, 2018 and May 27, 2020), meetings with both the New Tacoma and Northeast Tacoma Neighborhood Councils, one-on-one property owner/business operator meetings, discussions with other local and regional stakeholders, and coordination with Police, Fire, school districts and transit.  Open house notifications were provided through postcard mailings, social media, City and Project web pages, and advertising in The News Tribune and Tacoma Weekly. Website updates will be made during construction to provide information on upcoming work.



Where is the Taylor Way Rehabilitation Project?

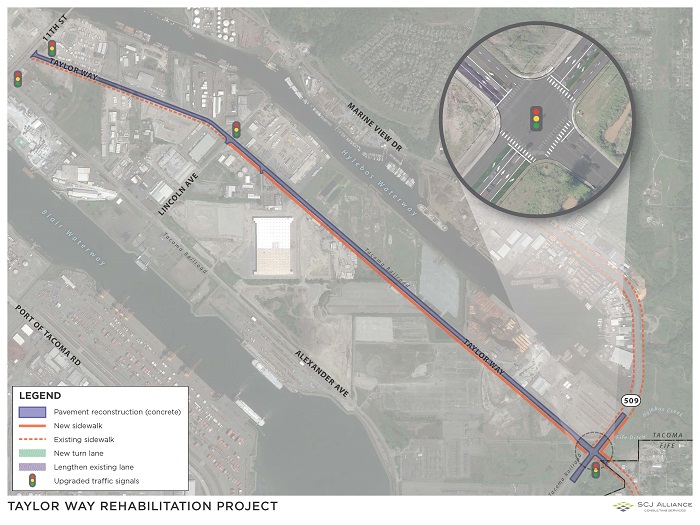

Project Map





























View a larger version of the project map



    What is the Project?

    Taylor Way is an important arterial serving the Port of Tacoma Manufacturing Industrial Center, it is the main corridor on the Blair-Hylebos Peninsula, an essential emergency access route, and a vital freight corridor for the Port carrying between 4 million tons and 10 million tons of freight every year.



    The Taylor Way pavement wasn't designed to carry these heavy truck loads. Truck and rail conflicts are common along the route, including 12 at-grade rail crossings between SR 509 and E. 12th Street.



    Although there is sidewalk between E. 11th Street and Lincoln Avenue, there are no pedestrian facilities along Taylor Way between Lincoln Avenue and SR 509.



    The SR 509/Taylor Way intersection is operating over capacity and delaying traffic on adjacent corridors. The intersection, as it currently operates, is the second worst ranked bottleneck for freight movement in WSDOT’s Olympic Region (Pierce, Thurston, Mason, Grays Harbor, Jefferson, Kitsap and Clallam Counties).



    What are the Project Needs and Proposed Improvements?



    Failing Pavement - Taylor Way was not built to handle the heavy truck loads. Over 40% of daily traffic on Taylor Way are trucks moving freight to/from the Port of Tacoma.



    Proposed Improvement

    • Rebuild Taylor Way as a concrete road from the Tacoma/Fife city limits (east of SR 509) to E. 11th Street. Concrete pavement will last much longer than asphalt with the heavy truck traffic.

    Congestion at the SR 509/Taylor Way Intersection – delays at this intersection impact regional traffic between I-5 and SR 509, as well as destinations within the Port, including along the Blair-Hylebos Peninsula.



    Proposed Improvement

    • Add second left turn lanes to SR 509 (both southbound and northbound).
    • Lengthen second thru lane and right-turn lane for westbound Taylor Way at SR 509.
    • Extend the length of the turn pockets on SR 509 and on Taylor Way.

    Lack of Pedestrian Facilities – currently there is sidewalk on the west side of Taylor Way between E. 11th Street and Lincoln Avenue, but there is no sidewalk along Taylor Way between Lincoln Avenue and SR 509. Pedestrians are forced to walk in the roadway or along a narrow dirt path adjacent to the curb.



    Proposed Improvement

    • Add a ten-foot wide sidewalk on the west side of Taylor Way between Lincoln Avenue and SR 509.
    • Build new energy-efficient LED street lighting.
    • Upgrade curb ramps at intersections and pedestrian push buttons at traffic signals.

    Response Time for Emergency Services/Freight Delays –Taylor Way is the “last mile” between I-5 and the Blair-Hylebos Peninsula, which includes major marine terminals and freight distributors. This takes on more importance with the closure of Alexander Avenue north of SR 509 and when the Hylebos Bridge is raised to pass marine vehicles. Taylor Way is also critical in providing emergency services to the Blair-Hylebos peninsula.



    Proposed Improvement

    • Reduce truck/rail conflicts by removing up to four of the 11 at-grade rail crossings, and by upgrading the remaining crossings to make the driving surface smoother so freight can maintain normal speeds while traversing the corridor.
    • Interconnect traffic signals for improved traffic flow.
    • Add closed circuit TV cameras to monitor traffic/freight movement and quickly respond to incidents.
    • Add LED signs/VMS boards providing messaging to freight/emergency response vehicles.
    • Add emergency vehicle pre-emption at traffic signals.

    How is the Project Funded?

    • Total Project Funding is $24 Million
    • Funding Partners:
      • City of Tacoma
      • Puget Sound Regional Council
      • Freight Mobility strategic Investment Board
      • Other Local Contributions

    When will the Project Be Built?

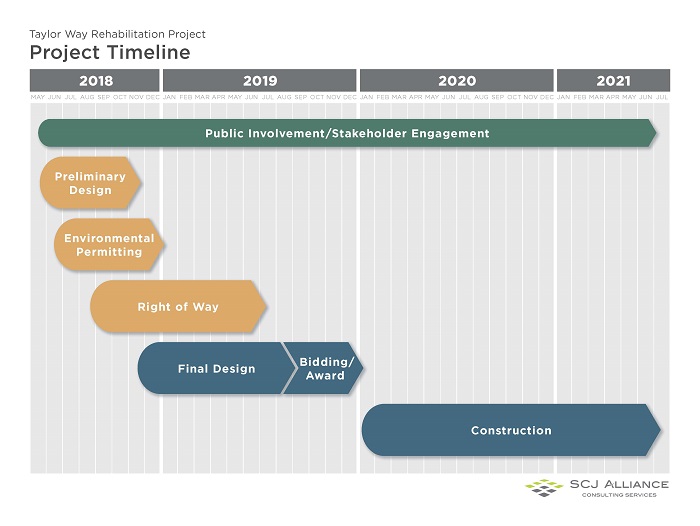

    Taylor Way Schedule

    Project Schedule



    Interested Groups

    The City is communicating with the following groups to provide updates and gather input:

    • Port of Tacoma

    • Puyallup Tribe of Indians

    • City of Fife

    • WSDOT

    • Longshoreman’s Local Union 23

    • Northwest Seaport Alliance

    • Tacoma Rail

    • Tacoma Transportation Commission

    • Tacoma Bicycle Pedestrian Technical Advisory Group

    • Tote Maritime

    • Carlile Transportation

    • Northeast and New Tacoma Neighborhood Councils

    Other Construction in the Area

    Use the following links to learn about other construction projects in the area.



    Related Environmental Documents

    Pre-Bid Construction Meeting

    Contact Information



    Please contact Mark D'Andrea, Project Manager, with any questions you have about the project at (253) 591-5518 or by email.
