South 19th St. and Clay Huntington

Project Description

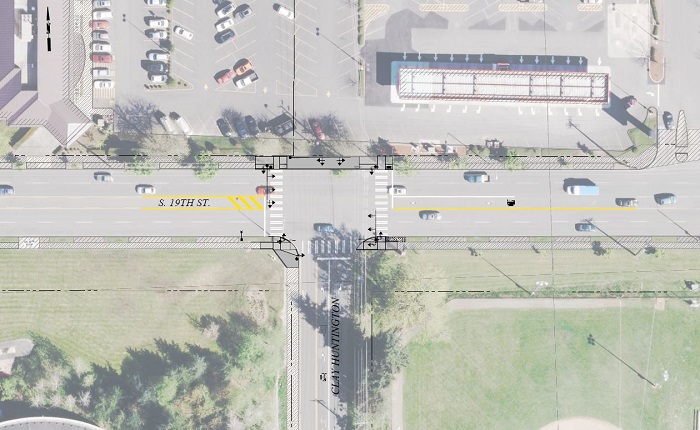

This project will install a new full traffic signal system at the intersection of Clay Huntington Way and S. 19th Street. Improvements at the intersection will also include accessible Pedestrian Signals (APS) push buttons and countdown signals, signage, pavement/crosswalk markings and curb ramps meeting ADA standards. The project improvements will provide an enhanced connection to Foss High School, and for pedestrians traveling to/from Cheney Stadium, Fred Meyer, Metro Parks Tacoma Headquarters, and Heidelberg Davis Park.



Clay Huntington



Project Funding

Funding Source Revenue
WSDOT grant $613,200
City of Tacoma (Grant Match) $118,200



Budget

Phase Amount
Design $83,200
Construction $648,200
Total $731,400



Schedule

Phase Estimated Start Date        Estimated Completion Date
Design Complete Complete
Ad & Award    Complete Complete
Construction  September 2021 (weather dependent) October 2021 (weather dependent)



Questions and Comments

Please contact Basel Kitmitto, Project Manager at (253) 591-5448 or by email with questions, concerns, or comments.



]]>
